Practical Tips for Eliminating Waste in Your Product Backlog

Less than one minute read Updated:

How to identify and remove hidden inefficiencies in your backlog using Lean principles.

A backlog is a factory floor, and every story sitting still on it is a part not moving toward Done.

Lean Thinking calls that unrealized value. Most product teams call it Tuesday. I have watched the same three symptoms show up at three different companies: features that never ship, half-finished stories nobody remembers starting, and bugs that sit open for a quarter because nobody owns the fix.

I run the system of record under InMobi’s ad exchange and DSP, the same one measuring 200M+ devices’ worth of ad events a day. The backlog under that platform used to accumulate exactly this kind of waste. This post is the five habits that cut it out, with the real numbers behind each one where I have them, and an honest gap where I do not.

So that’s today’s post.

Today’s Post

Five habits, in the order I’d apply them to a backlog that’s grown legs.

  • Audit the backlog on a fixed cadence, not when it feels overdue
  • Prioritize ruthlessly by tying every story to an outcome
  • Treat bugs as a broken window, not a someday item
  • Delete handoffs instead of managing them
  • Run retrospectives that end in a decision, not a discussion

1. Audit your backlog on a schedule

Most backlogs do not get reviewed. They get remembered, in a panic, right before planning.

Stale threshold: any story untouched for 14 days needs a product manager’s decision, kept with an owner and a date, revalidated, or deleted. Fourteen days is short enough that nothing rots for a full quarter and long enough that you are not reviewing yesterday’s ticket.

Put a “To Validate” bucket in front of the real backlog. An idea earns its way into the sprint-ready column only after someone can state the outcome it is supposed to move. Everything else waits there, visibly, instead of quietly inflating the count of “things we’re doing.”

Here is the discipline in practice. At Pixis, 15+ voice-of-customer interviews on the Prism launch became exactly five roadmap features. The other forty ideas were real, someone wanted each of them, and the team declined them anyway. That ratio, five kept out of forty-five heard, is what a monthly audit is supposed to produce on every backlog, not just the launch backlog.

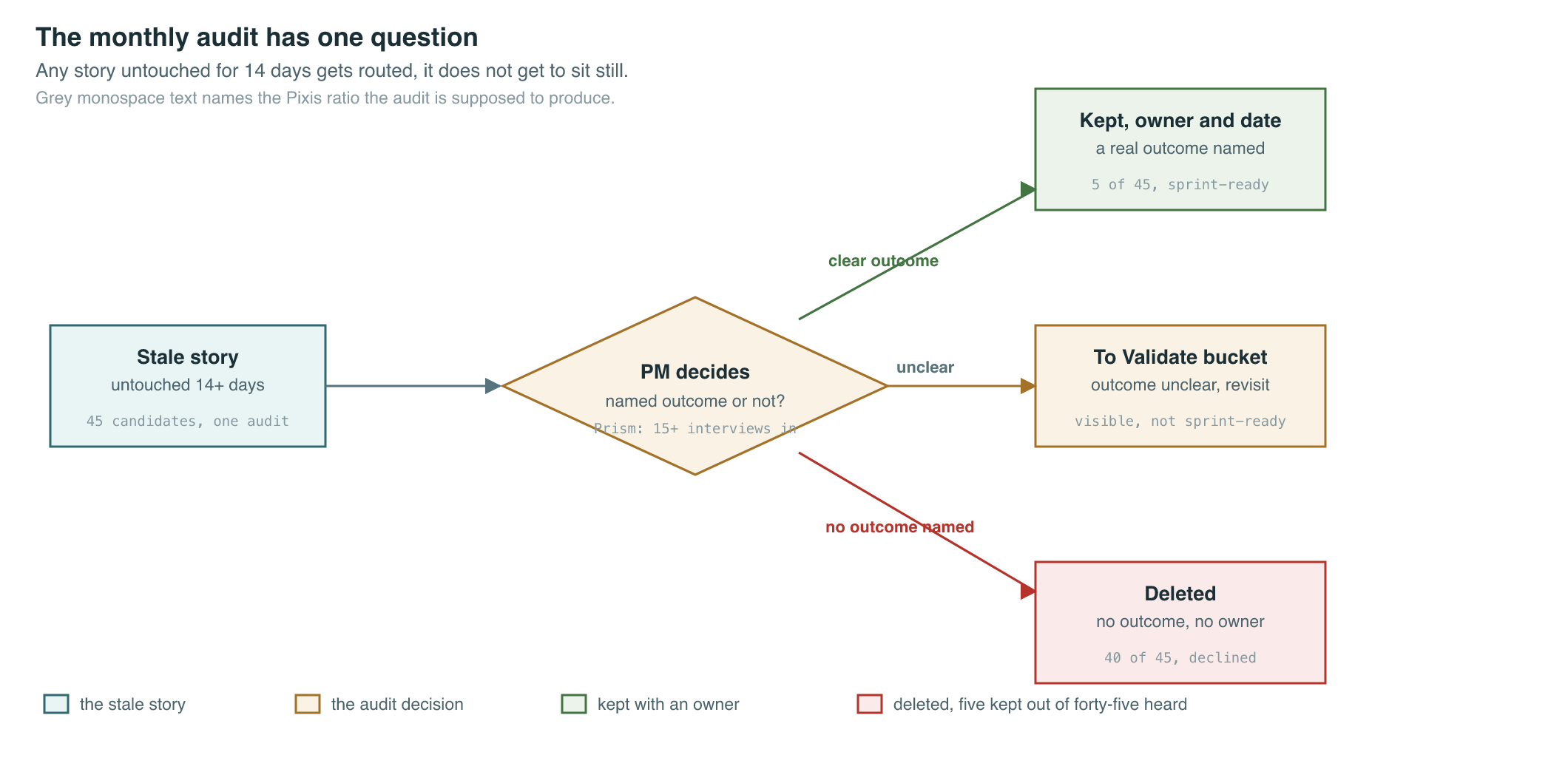

The monthly audit has one question Any story untouched for 14 days gets routed, it does not get to sit still. Grey monospace text names the Pixis ratio the audit is supposed to produce. Stale story untouched 14+ days 45 candidates, one audit PM decides named outcome or not? Prism: 15+ interviews in Kept, owner and date a real outcome named 5 of 45, sprint-ready To Validate bucket outcome unclear, revisit visible, not sprint-ready Deleted no outcome, no owner 40 of 45, declined clear outcome unclear no outcome named the stale story the audit decision kept with an owner deleted, five kept out of forty-five heard
Every stale story gets a decision, not a shrug. Five of forty-five made it through on the Prism launch. PNG ↓

I’d grade a backlog with no stale threshold a 2/10 on Lean discipline, no matter how good the stories inside it are.

2. Prioritize by outcome, not by comfort

The 80/20 rule says a fifth of your backlog drives most of the value. Knowing the rule is easy. Admitting which fifth you’re actually in is the hard part.

Tie every story to an outcome. If you cannot name the number a story is supposed to move, and by how much, it is not ready for the sprint. That is not a formality. It is the same test the InMobi close passed and most feature requests fail: a reconciliation pipeline shipped as an output, and the outcome was the close moving from 5 days to 12 hours. A backlog full of “ship the button” stories with no outcome attached is a backlog full of uninstrumented bets.

Limit work in progress. Every story half-open at once is a story not shipping. At Pixis the AdRoom team ran the opposite of a sprawling backlog: one hard goal per two-week onboarding sprint, one metric, activation, and nothing else competing for attention. Four brands into that discipline the sprint had produced $800K ARR in two months, and the wider motion reached $0 to $10M ARR in five months with a 20-person team. None of that came from doing more things. It came from doing fewer, on purpose.

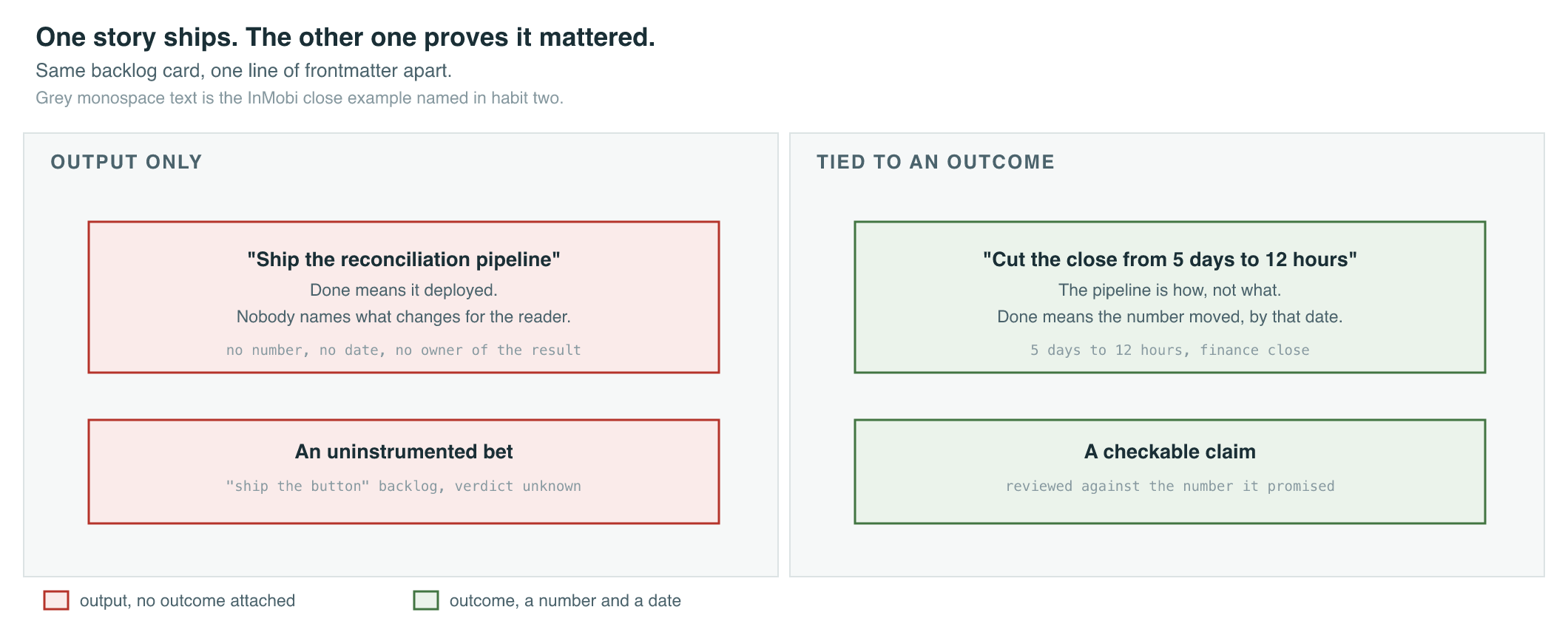

One story ships. The other one proves it mattered. Same backlog card, one line of frontmatter apart. Grey monospace text is the InMobi close example named in habit two. OUTPUT ONLY TIED TO AN OUTCOME "Ship the reconciliation pipeline" Done means it deployed. Nobody names what changes for the reader. no number, no date, no owner of the result An uninstrumented bet "ship the button" backlog, verdict unknown "Cut the close from 5 days to 12 hours" The pipeline is how, not what. Done means the number moved, by that date. 5 days to 12 hours, finance close A checkable claim reviewed against the number it promised output, no outcome attached outcome, a number and a date
Same work, one line of frontmatter apart. Only one of them is checkable later. PNG ↓

3. Treat every bug like a broken window

Here’s the uncomfortable part of Lean backlogs: bugs are waste too, and they compound.

The broken window theory, borrowed from urban planning, says one unrepaired window invites the next one, and the one after that. A backlog works the same way. The first bug left open all sprint tells the team that quality is optional. The tenth bug left open makes it official.

One ignored bug attracts three more The quality bar drops a step every sprint nobody fixes the first window. Grey monospace text is the open-bug count at each sprint. Scroll slowly, this plays once. Sprint 1 One bug left open 1 open bug bar: high Sprint 2 A second one joins it 2 open bugs bar: slipping Sprint 3 A third, nobody's surprised 3 open bugs bar: low Sprint 4 Quality is optional now 4 open bugs, official bar: gone
Nobody decided to lower the bar. It dropped one un-fixed bug at a time. (animates as you scroll to it) PNG ↓

The fix is a dedicated bug slot, fixed capacity every sprint that exists whether or not anyone feels like using it, the same way finance’s month-end close happens twelve times a year whether anyone likes it or not. A promise to get to it later is a suggestion. A slot on the sprint board is a commitment.

Root cause matters more than the fix itself. Ask why the bug shipped: unclear requirements, thin test coverage, missing acceptance criteria. Fix the process once and you stop paying for the same class of bug every sprint.

4. Delete the handoff, don’t manage it

A handoff is what happens when two groups treat a boundary as the place responsibility transfers. That boundary is where most backlog waste gets manufactured, one round trip at a time.

Product “hands off” a spec. Engineering “hands back” a build. QA “hands off” a release. Each pass is a chance for the original outcome to leak out of the story entirely, and the PM-engineering relationship post on this site walks through why that structure, not the people in it, is the actual bug.

Cross-functional pods fix this by removing the boundary instead of staffing around it. A pod of engineers, APMs, and designers that owns a story end to end has nowhere to hand it off to. Shared documentation, one place for specs, designs, and decisions, cuts the second source of rework: the meeting that exists only because two people read different versions of the same doc.

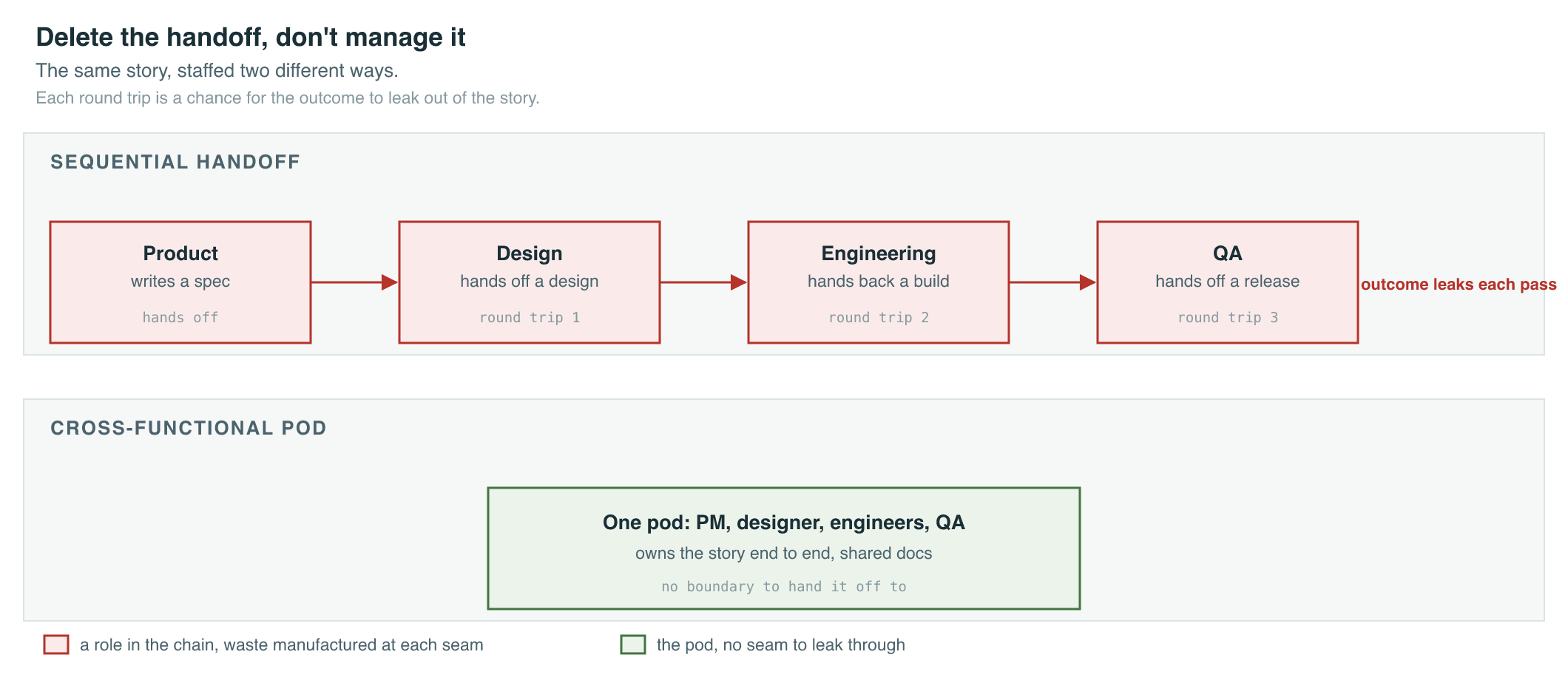

Delete the handoff, don't manage it The same story, staffed two different ways. Each round trip is a chance for the outcome to leak out of the story. SEQUENTIAL HANDOFF CROSS-FUNCTIONAL POD Product writes a spec hands off Design hands off a design round trip 1 Engineering hands back a build round trip 2 QA hands off a release round trip 3 outcome leaks each pass One pod: PM, designer, engineers, QA owns the story end to end, shared docs no boundary to hand it off to a role in the chain, waste manufactured at each seam the pod, no seam to leak through
Four seams for the outcome to leak through, versus zero. PNG ↓

5. End every retrospective with a decision

A retrospective that surfaces problems and stops there is a retrospective that will surface the same problems next month.

Ask two questions and write down the answer to both. Which backlog items turned out to be unnecessary? Which items sat in progress too long? Neither question is rhetorical. If design sign-off is the bottleneck every single retro, that is not a discussion topic anymore. It is a decision waiting to be made, and my own rule from the home page applies here too: unwritten means undecided.

The same log that records what you decided is what makes the next audit in habit one actually fast. Without it, every stale story gets re-litigated from scratch.

Takeaways

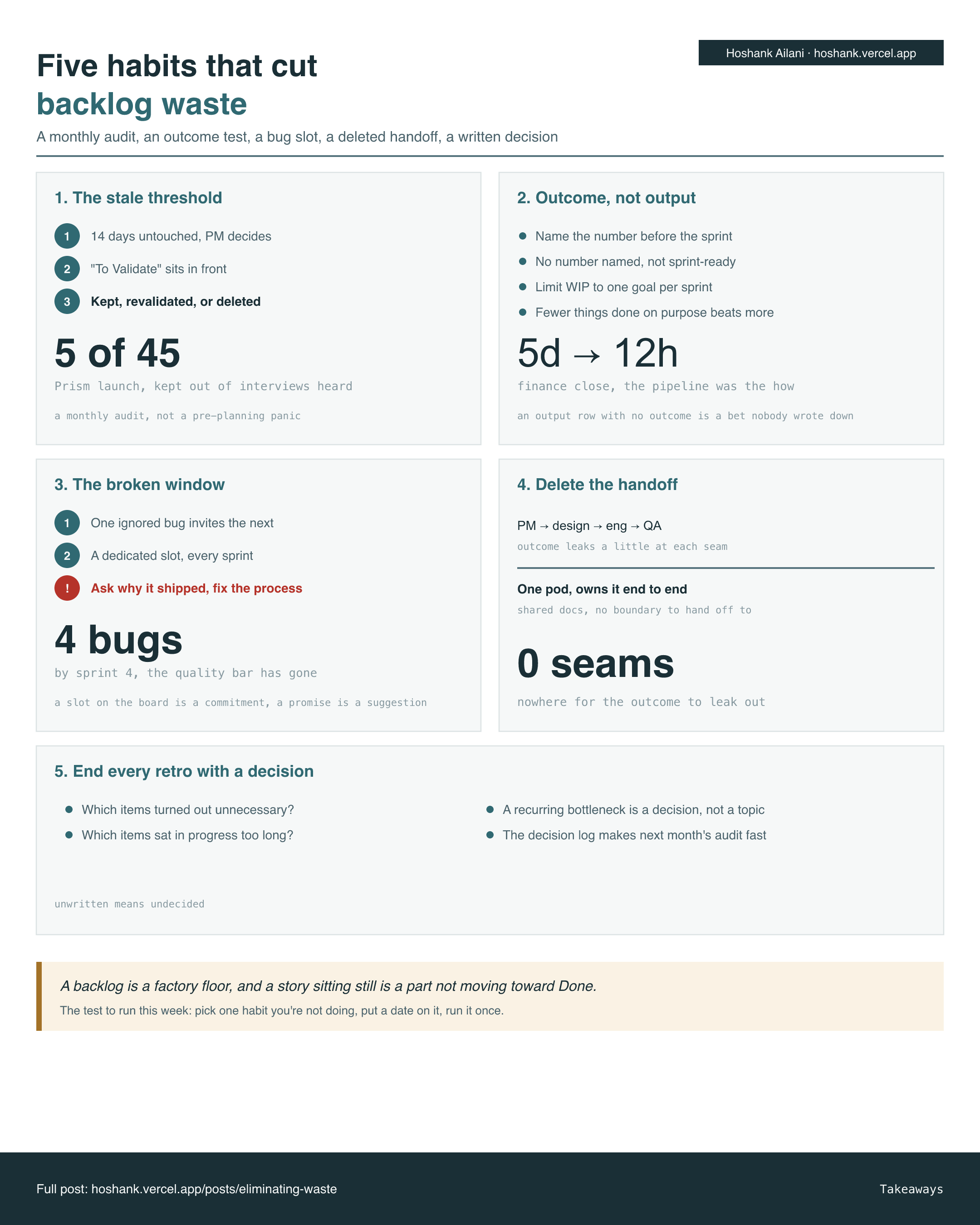

Five habits that cut backlog waste A monthly audit, an outcome test, a bug slot, a deleted handoff, a written decision Hoshank Ailani · hoshank.vercel.app 1. The stale threshold 1 14 days untouched, PM decides 2 "To Validate" sits in front 3 Kept, revalidated, or deleted 5 of 45 Prism launch, kept out of interviews heard a monthly audit, not a pre-planning panic 2. Outcome, not output Name the number before the sprint No number named, not sprint-ready Limit WIP to one goal per sprint Fewer things done on purpose beats more 5d → 12h finance close, the pipeline was the how an output row with no outcome is a bet nobody wrote down 3. The broken window 1 One ignored bug invites the next 2 A dedicated slot, every sprint ! Ask why it shipped, fix the process 4 bugs by sprint 4, the quality bar has gone a slot on the board is a commitment, a promise is a suggestion 4. Delete the handoff PM → design → eng → QA outcome leaks a little at each seam One pod, owns it end to end shared docs, no boundary to hand off to 0 seams nowhere for the outcome to leak out 5. End every retro with a decision Which items turned out unnecessary? Which items sat in progress too long? A recurring bottleneck is a decision, not a topic The decision log makes next month's audit fast unwritten means undecided A backlog is a factory floor, and a story sitting still is a part not moving toward Done. The test to run this week: pick one habit you're not doing, put a date on it, run it once. Full post: hoshank.vercel.app/posts/eliminating-waste Takeaways
The whole post on one card. Save it, share it, argue with it. PNG ↓

Five panels, one per habit. The callout is the same test as the audit: if a story’s been sitting for 14 days with no owner and no date, it’s not backlog, it’s waste.

Final Words

None of these five habits are complicated. The hard part is running them on a schedule instead of when the backlog finally embarrasses someone in a planning meeting. Pick one habit you’re not doing, put a date on your calendar this week, and run it once.

Reply and tell me which one you picked. I’m collecting the results for a follow-up.

Cheers, Hoshank
