A clean backlog and a working product are two different claims, and most PMs only ever prove the first one.
Ask five people on a team what they are trying to change for the customer this month, and how they will know. If the answers all point at Jira, you have a coordination system. You do not have a strategy.
I have owned the “how will we know” half of that question at three companies now: supply-chain platforms at Dell, a 20-person AI creative team at Pixis, and the system of record under InMobi’s ad exchange, which reads roughly 200 million devices’ worth of events a day. The pattern repeats everywhere. The backlog gets treated like the product, and the actual product quietly drifts.
So that’s today’s post.
Today’s Post
Why backlog hygiene feels like leadership, and what to do instead, in five sections.
- Why a groomed backlog is not a strategy
- The fear that hides inside ticket hygiene
- Outputs versus outcomes, with real numbers
- What delegation looks like when it is real
- How a single surprise tells you which PM you are watching
1. The backlog is not the strategy
Most PMs think their job is to keep the backlog clean.
A clean backlog means the tickets are well written, ordered, and estimated. People nod at it in the Monday standup.
A strategy means the team can state, without opening a tool, what has to change for the customer and why these efforts should produce that change. It includes tradeoffs and a list of things you are deliberately not doing.

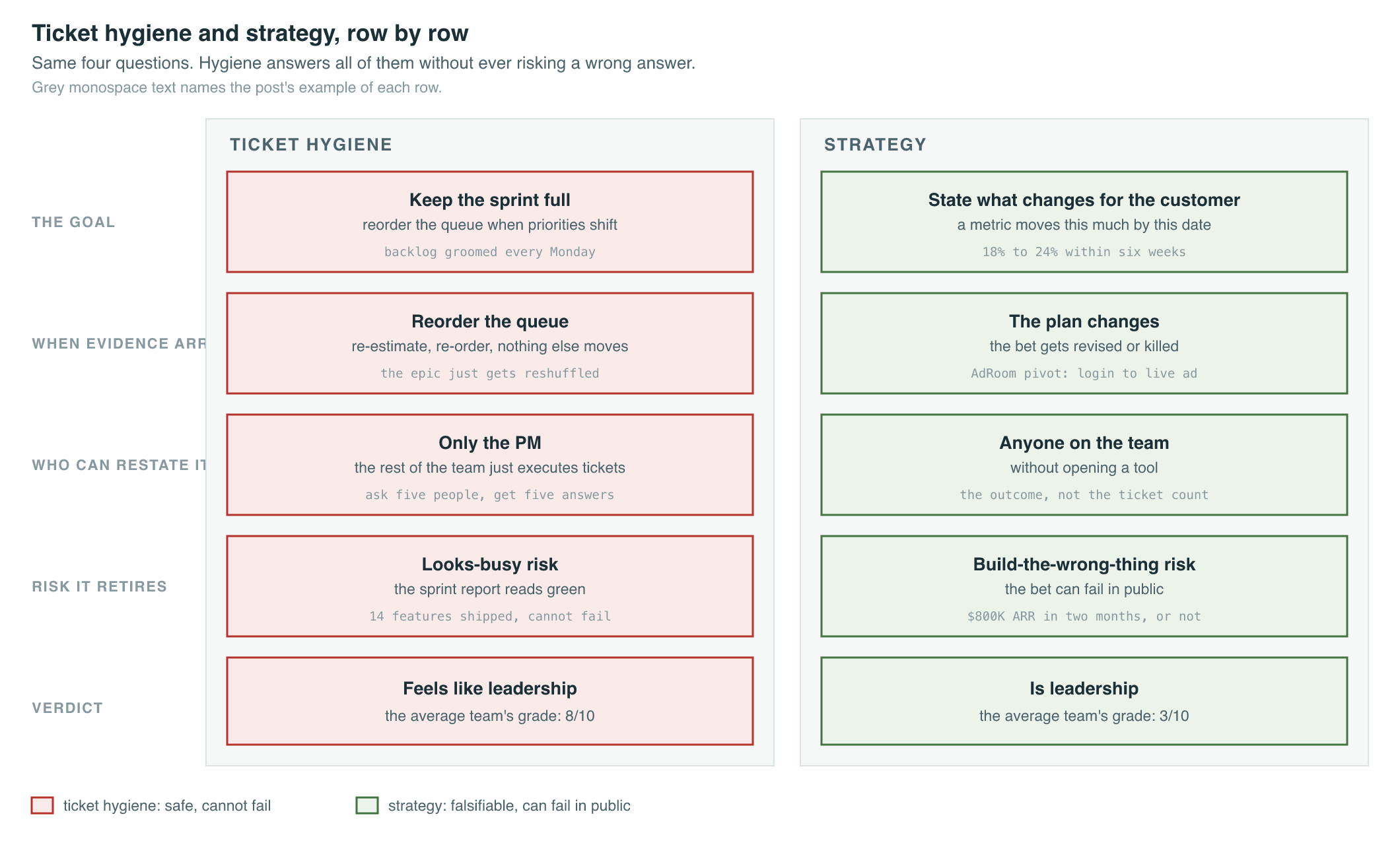

I would grade the average team a 8/10 on ticket hygiene and a 3/10 on strategy, and the two scores have almost nothing to do with each other.
Here is why that gap survives so long. A groomed backlog produces evidence every week: a diff, a burndown chart, a closed ticket. A strategy produces evidence on the calendar you wrote down for it, which might be six weeks out. Given a choice between weekly proof and six-week proof, most organizations reward the weekly one.
2. The fear inside ticket hygiene
Micromanaging tickets is rarely loud. It shows up as rewriting other people’s stories, re-estimating someone else’s task, or reordering an epic because a spreadsheet changed.
Falsifiable claim: “This feature will lift the metric by this much, in this window.” That sentence can be wrong, and being wrong in public is uncomfortable. Ticket hygiene never makes that claim, so it can never be wrong.
Compare the two things a PM can put their name on. “I shipped 14 features this quarter” cannot fail. “I bet self-serve, on-brand creation would replace the approval queue, and I was right within two months” can fail in front of everyone.
That second sentence is close to a real one. At Pixis, the AdRoom team’s bet on the approval queue was tested with a two-week onboarding sprint and one hard goal, get the brand self-serving live, on-brand ads inside the window. We instrumented the live ad, not the login. Four brands into that test, the sprint had produced $800K in ARR in two months, and the wider motion went from $0 to $10M ARR in five months with a 20-person team. Writing that bet down before the sprint started is what made it falsifiable. Grooming a backlog never puts a PM in that position, which is exactly why grooming a backlog is the safer job.
3. Outputs versus outcomes, with numbers on both sides
Outputs are things a team produces: features, releases, documents. They are fully inside the team’s control.
Outcomes are changes in the world: a shorter close, a higher activation rate, a system nobody has to babysit. They are only partly inside the team’s control, and partly hostage to sales, support, and whether the feature solved the real problem.

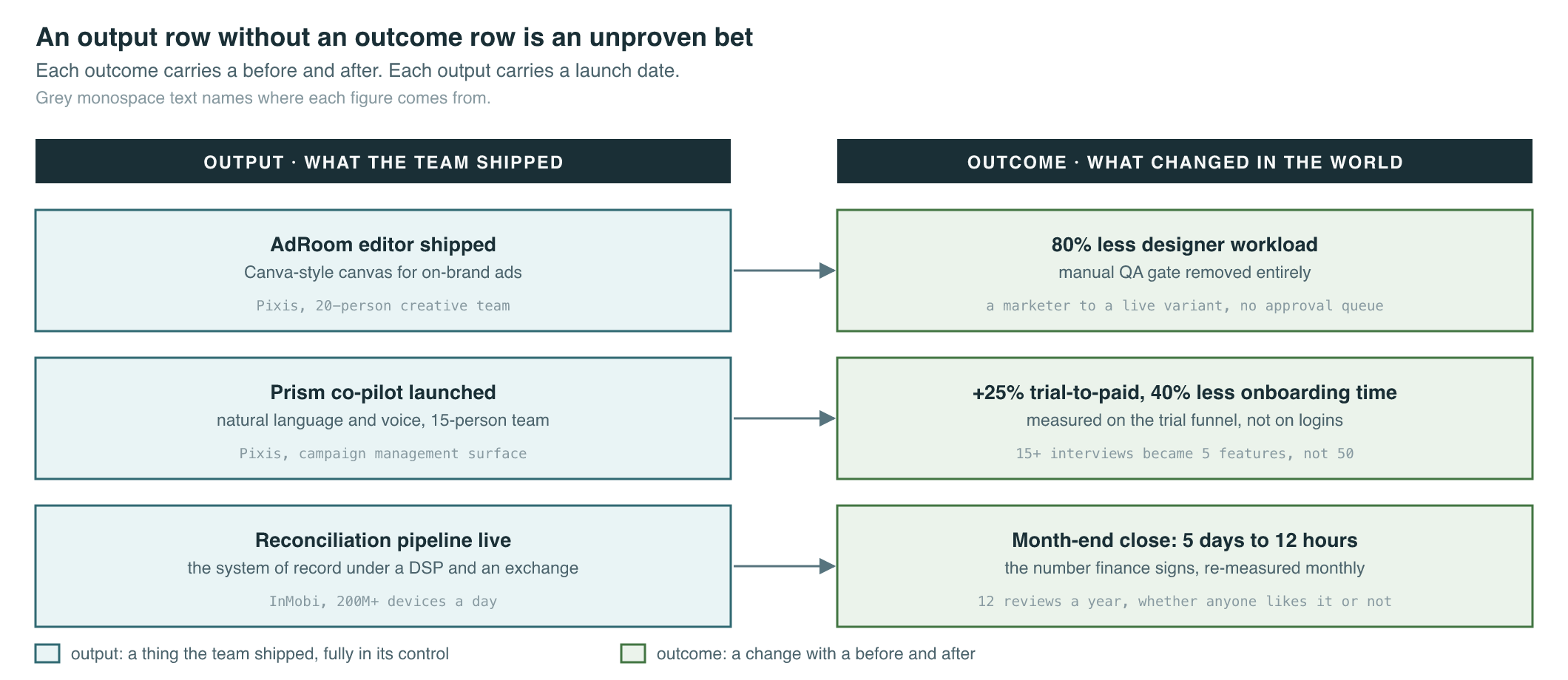

Put a real number on each side of the same project and the gap is obvious. At Pixis, the output was AdRoom’s editor, a Canva-style canvas for on-brand ads. The outcome was an 80% cut in graphic-designer workload and the elimination of the manual QA gate that used to sit between a marketer and a live variant. The output for Prism was a natural-language and voice co-pilot, built by a 15-person team I led. The outcome was trial-to-paid up 25% and onboarding time down 40%.
The advance-layer engine underneath Pixis’s Advance product tells the same story from the infrastructure side. The output was a 12-person pod and a data platform. The outcome was 1M+ keywords a day processed for 400+ enterprise customers at 99.6% end-to-end sync reliability, with delay cut from 4 hours to under 15 minutes. A backlog full of well-groomed tickets says nothing about any of those four numbers. Only a team that decided in advance what “working” meant could report them.
4. What real delegation looks like
Delegation is not the absence of management. It is management aimed at a different layer.
The PM owns the outcome, the timeframe, and the constraints. The team owns how to slice the work, what to spike, and when to push back. Under that split, the backlog becomes the team’s coordination tool, not the PM’s control lever.
That split only works with trust running in both directions. The team has to believe leadership will not move the goalposts without naming the change. Leadership has to believe the team will surface bad news early, not bury it in a green sprint report.
I run this the way I ran voice-of-customer research on Prism’s launch: 15-plus interviews became exactly five roadmap features, not fifty. The hard part was not gathering opinions. The hard part was declining the other forty, in front of the people who asked for them, with a stated reason each time. That discipline is what a delegated team looks like from the outside, a short list, clearly defended, instead of a backlog that grew because saying no felt harder than adding a card.
5. How a surprise tells you which PM you are watching
Surprises are not the exception in product work. They are the job.
Watch what happens when scope creeps, when engineering says a feature is harder than planned, or when sales asks for a one-off. The two responses look almost identical from a distance and are opposites up close.

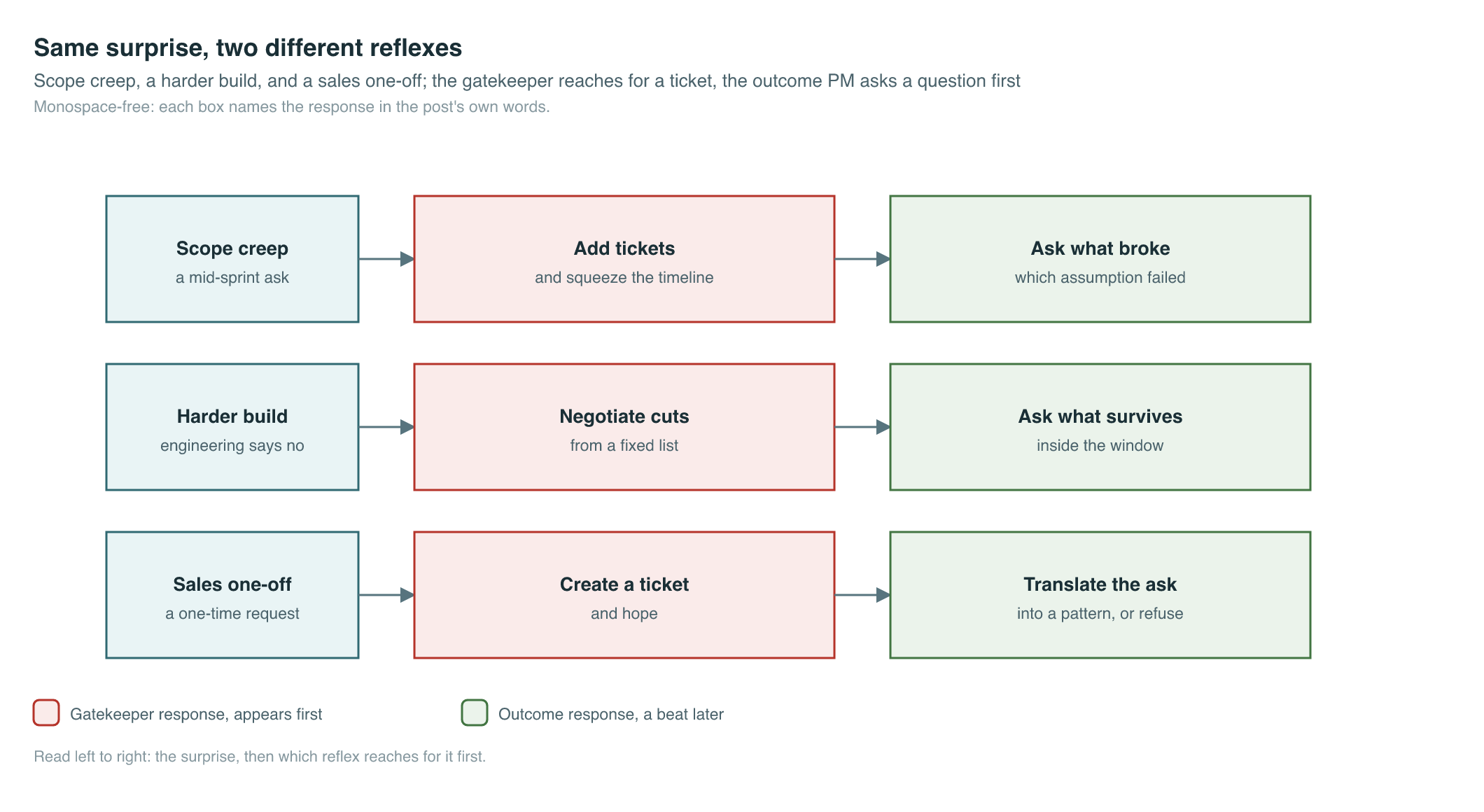

The gatekeeper PM manages the backlog. The outcome PM manages the bet, and treats the backlog as one of the things that changes when the bet changes.
Both responses look like leadership in a status update. Only one of them is checking whether the underlying plan still makes sense.
Takeaways
Five panels, one per section. The callout is the test to run on your own backlog this week.
Final Words
Most teams already have a backlog that looks disciplined. What they are missing is a written bet, a review on the date they promised, and a habit of asking what assumption broke before reaching for a new ticket. Pick the epic your team is grooming hardest right now and ask whether anyone could restate its outcome without opening the tool.
Reply and tell me what you found.
